To help keep area residents informed of our construction progress, we will post project updates to this site on a regular basis. Click here to see status updates.

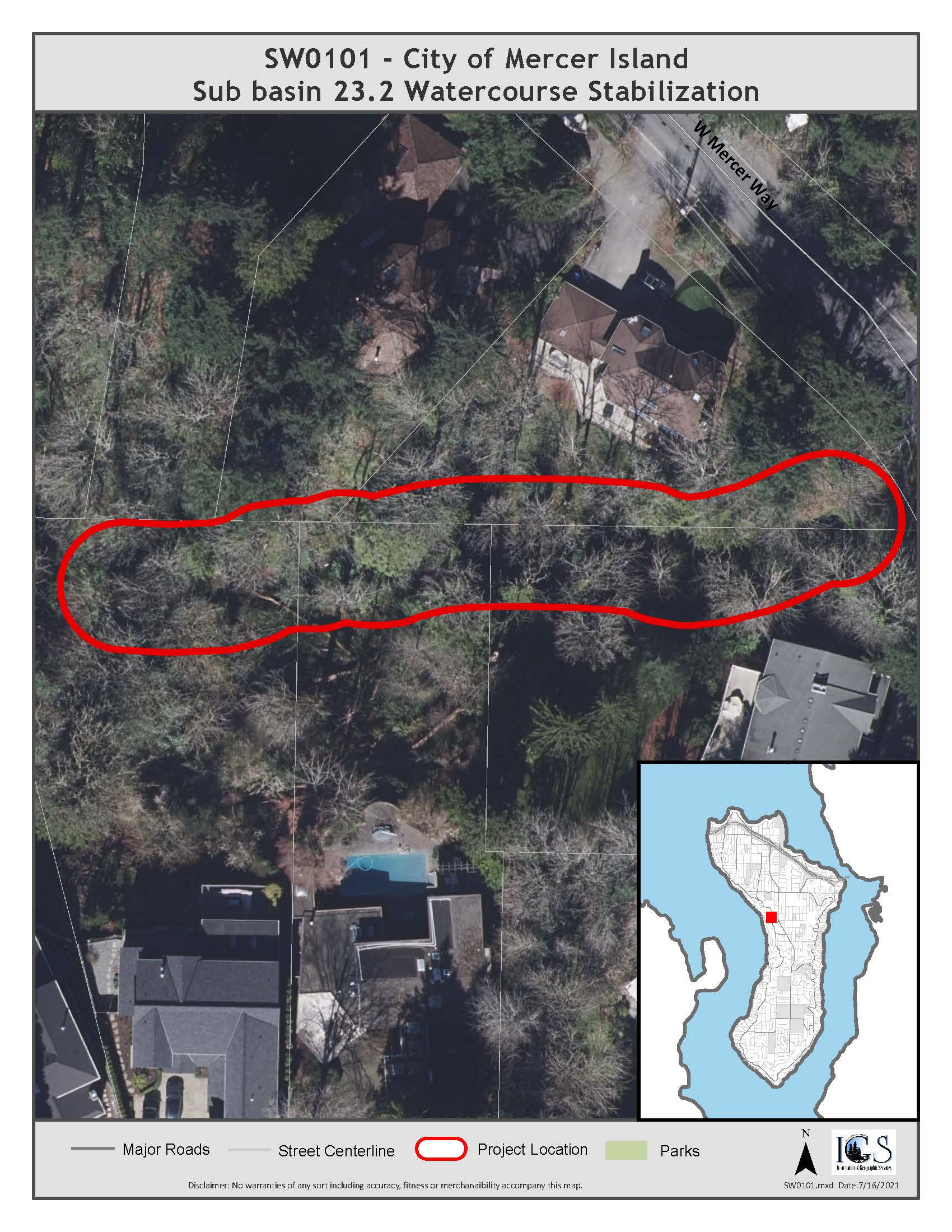

Project Details/Neighborhood
Watercourse adjacent to 4324 West Mercer Way
Background
This sub-reach has numerous headcuts. The channel has incised up to 15 feet into the bed pan. This condition poses risks to adjacent areas, private street, banks and upper slope stability, increased sedimentation, and loss o f habitat.
Description
Stabilize the upper 250 feet of watercourse adjacent to 4324 West Mercer Way by regrading and filling channel. Install boulder cascade at headcuts and beyond.

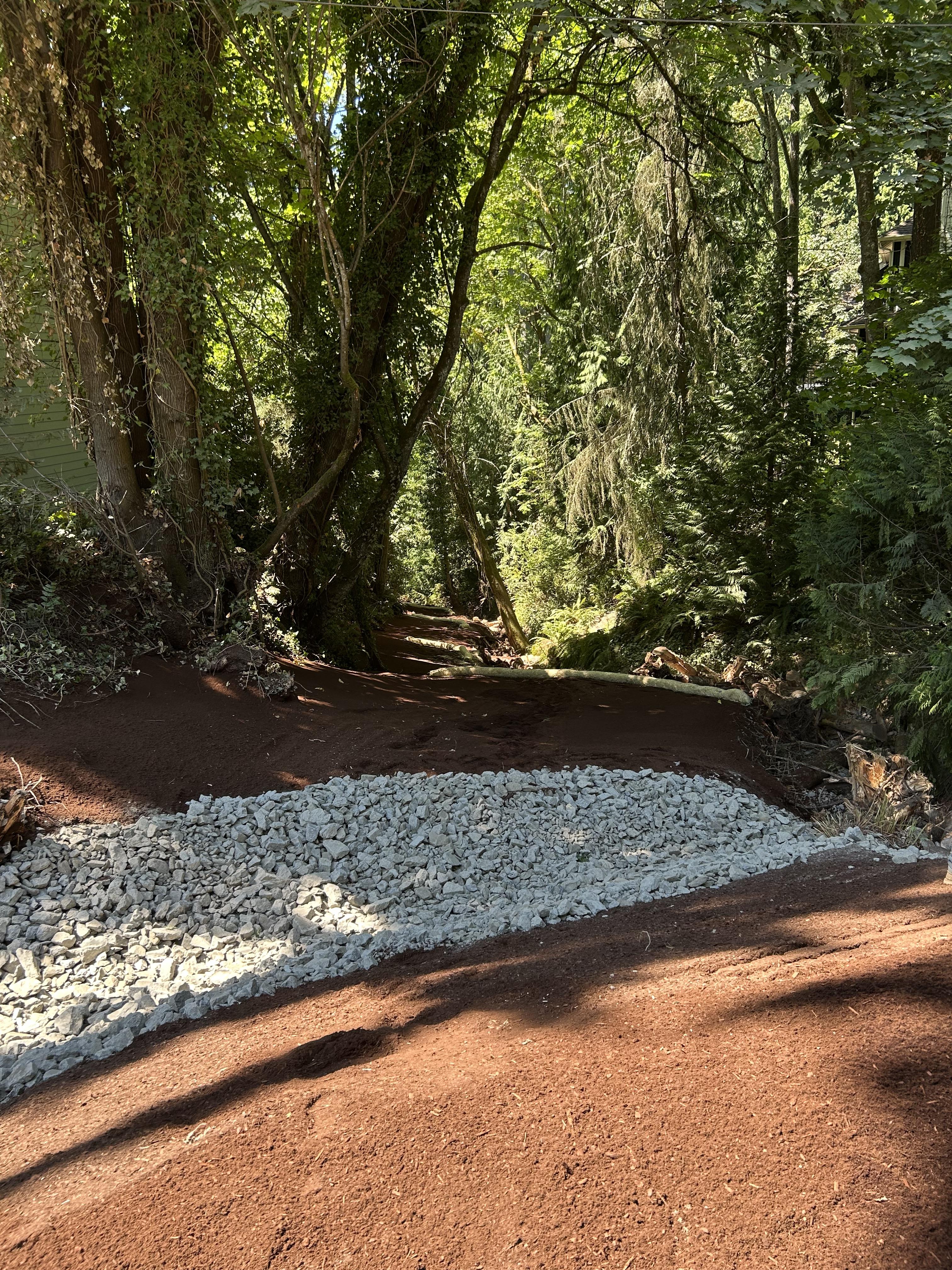

Construction continued this week to improve approximately 300 feet of open watercourse channel located north of SE 44th Street and west of West Mercer Way. The contractor has installed stream boulders, logs, and root wads to the stream to protect it from further downcutting and erosion. Stream bed work is planned to be substantially completed next week, with replanting and landscaping to occur in the fall.
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
April 2025
The City received three bids for this project and is currently in the process of finalizing a contract. Construction is scheduled to begin in June 2025 and is expected to continue through early fall.
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
March 2025
The project information was sent to registered Contractors on the MRSC Small Works Roster for Stream Restoration. On March 27, PW staff hosted an on-site visit for prospective bidders to view the watercourse and ask questions about the proposed work. Bids are due on April 7, 2025. Construction of this project, located in the 4300 block of West Mercer Way, is expected in Summer 2025.
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
February 2025
The City has received the final plans and specifications for the project and is now preparing it for bidding. The construction is planned for summer 2025.
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
May 30, 2024 Due to the construction time-frame mandated by the regulatory permit, the construction schedule for this project has been shifted to the summer of 2025. Future updates for this project page will be provided in early 2025 with the commencement of the bidding process for contractor selection.
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
April 2024
Final design comments were sent to the consultant to incorporate into plans and specifications.
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
October 2023
We have received the US Army Corps of Engineers permit for this project. All required permits are now complete. Construction is planned for July and August 2024.
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
May 2022
The project received its Hydraulic Project Approval (HPA) from Washington Department of Fish and Wildlife on April 20. The HPA states that any work below the ordinary high water line (OHWL) of the stream shall be conducted between June 1 and September 30. This timing limitation is also known as the “fish window”. Therefore, obtaining the necessary permit from the US Army Corps of Engineers (USACE) in-time is key to having this project constructed this year within the timing limitation. As of the end of April, the USACE could not estimate a permit decision date citing lack of resources. The USACE indicates that it is in the process of hiring additional project managers to handle their workload.
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
April 2022
The project is currently in the permit review phase with the following two agencies.
Washington Department of Fish and Wildlife since March 2022.
US Army Corps of Engineers since March 2021.
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
February 2022
The project is currently in permit review with the US Army Corps of Engineers (USACE). The agency has been requesting design-related clarifications and the design team has been responding accordingly.
In December, SEPA review application was submitted. Public Notifications sent to the neighborhood on 1/10/22, with the public comment period ending on February 9th.
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
Opens in new window
PDF Download
Word Download
Excel Download
PowerPoint Download
Document Download
November 2021
The project is currently in permitting review with US Army Corps of Engineers (USACE). The agency has been requesting design-related clarifications and the design team has been responding accordingly.
